20                                                         AFMAN15-111  12 MARCH 2019

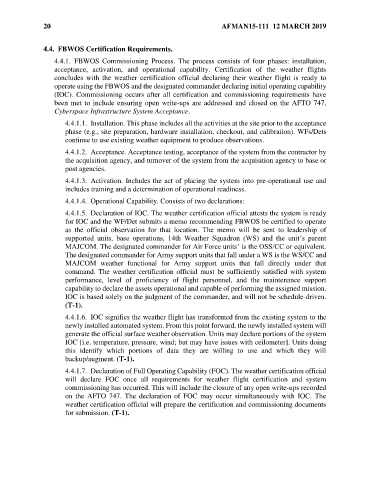

               4.4.  FBWOS Certification Requirements.

                   4.4.1.  FBWOS  Commissioning  Process.  The  process  consists  of  four  phases:  installation,
                   acceptance,  activation,  and  operational  capability.  Certification  of  the  weather  flights
                   concludes  with  the  weather  certification  official  declaring  their  weather  flight  is  ready  to
                   operate using the FBWOS and the designated commander declaring initial operating capability
                   (IOC). Commissioning occurs after all certification  and commissioning requirements have
                   been met to include ensuring open write-ups are addressed and closed on the AFTO 747,
                   Cyberspace Infrastructure System Acceptance.
                       4.4.1.1.  Installation. This phase includes all the activities at the site prior to the acceptance
                       phase (e.g., site preparation, hardware installation, checkout, and calibration). WFs/Dets
                       continue to use existing weather equipment to produce observations.
                       4.4.1.2.  Acceptance. Acceptance testing, acceptance of the system from the contractor by
                       the acquisition agency, and turnover of the system from the acquisition agency to base or
                       post agencies.
                       4.4.1.3.  Activation. Includes the act of placing the system into pre-operational use and
                       includes training and a determination of operational readiness.

                       4.4.1.4.  Operational Capability. Consists of two declarations:
                       4.4.1.5.  Declaration of IOC. The weather certification official attests the system is ready
                       for IOC and the WF/Det submits a memo recommending FBWOS be certified to operate
                       as  the  official  observation  for  that  location.  The  memo  will  be  sent  to  leadership  of
                       supported  units,  base  operations,  14th  Weather  Squadron  (WS)  and  the  unit’s  parent
                       MAJCOM. The designated commander for Air Force units’ is the OSS/CC or equivalent.
                       The designated commander for Army support units that fall under a WS is the WS/CC and
                       MAJCOM  weather  functional  for  Army  support  units  that  fall  directly  under  that
                       command. The weather  certification official must be sufficiently  satisfied with  system
                       performance,  level  of  proficiency  of  flight  personnel,  and  the  maintenance  support
                       capability to declare the assets operational and capable of performing the assigned mission.
                       IOC is based solely on the judgment of the commander, and will not be schedule-driven.
                       (T-1).
                       4.4.1.6.  IOC signifies the weather flight has transformed from the existing system to the
                       newly installed automated system. From this point forward, the newly installed system will
                       generate the official surface weather observation. Units may declare portions of the system
                       IOC [i.e. temperature, pressure, wind; but may have issues with ceilometer]. Units doing
                       this  identify  which  portions  of  data  they  are  willing  to  use  and  which  they  will
                       backup/augment. (T-1).

                       4.4.1.7.  Declaration of Full Operating Capability (FOC). The weather certification official
                       will  declare  FOC  once  all  requirements  for  weather  flight  certification  and  system
                       commissioning has occurred. This will include the closure of any open write-ups recorded
                       on  the  AFTO  747.  The  declaration  of  FOC  may  occur  simultaneously  with  IOC.  The
                       weather certification official will prepare the certification and commissioning documents
                       for submission. (T-1).
